Cloud ETL vs. On-Premise ETL: Total Cost of Ownership Analysis

Cloud ETL vs. On-Premise ETL total cost of ownership, compared across upfront spend, scaling, staffing, compliance, and hybrid deployment.

Summarize with AI:

Teams comparing cloud and on-premise ETL usually settle it on the quote, and the quote predicts almost nothing about which one costs less over three years. Whether a pipeline runs on infrastructure a vendor operates and meters, or on servers your own team buys and houses, the same costs follow it across its whole life, including licenses or subscriptions, infrastructure, staffing, compliance audits, data transfer, maintenance, and downtime.

Total cost of ownership (TCO) counts all of them, and on that arithmetic the cheaper deployment depends on your demand curve more than on the platform.

This comparison covers the cost factors common to both deployments, how each behaves against them, where hybrid models fit, and how to model your own workload.

TL;DR

  • Both deployments pay into the same five cost categories, and the comparison turns on how each one bills them.
  • Cloud trades a hardware purchase for a subscription and then charges configured capacity and runtime, so retries, warm-ups, and mis-sized workers bill for work that never lands.
  • On-premise front-loads the spend and sizes hardware for the busiest week, buying a bill that stays flat when demand does not.
  • Hybrid splits the bill across vendor control-plane charges and customer-paid data-plane infrastructure, so a model that prices only one of them is wrong by construction.
  • The cheapest deployment is the one whose demand curve matches its billing model, which only your own base, growth, and stress scenarios can show.

Try Airbyte Flex

What Factors Impact TCO for ETL Pipelines?

Five categories account for most of what an ETL pipeline costs over its lifetime, whichever deployment runs it:

  1. Licensing or subscription fees: commercial licenses, renewals, or metered platform charges.
  2. Infrastructure and hardware: servers, storage, and networking gear, or the usage bill that replaces them.
  3. Staffing and day-to-day operations: administrators, on-call coverage, and performance tuning.
  4. Maintenance and vendor support: hardware and software maintenance contracts and tiered support plans.
  5. Security and compliance: access controls, encrypted storage, audits, and the evidence work behind them.

Ongoing costs usually outweigh the initial investment in data integration software. Renewals, maintenance contracts, and salaries recur every year, and hardware refreshes arrive on a cycle of their own. Regulated industries carry additional cost considerations on top of these five, including compliance audits, encrypted storage, and region-locked capacity.

The ETL platform you choose decides which of these you pay directly and which arrive folded into a usage bill, so the same five categories can produce very different invoices.

How Do Cloud and On-Premise ETL TCO Compare?

Cloud reduces upfront infrastructure investment and absorbs elastic capacity. On-premise demands a larger initial outlay in exchange for customer-managed infrastructure and predictable provisioned capacity. The table below maps the five cost factors onto both deployments before the sections that follow examine each one in depth.

Cost CategoryCloud ETLOn-Premise ETL
Licensing and service feesPay-as-you-go or subscriptionCommercial license plus renewals
Infrastructure and hardwareIncluded in usage feesServers, storage, networking equipment
StaffingLean team with oversightDedicated administrators, salaries and on-call
Maintenance and supportOptional or tiered vendor supportHardware and software maintenance contracts
Security and complianceVendor certifications plus configuration costsCustomer-managed controls and audit spend
Initial implementationLower setup cost, varying with complexityHigher setup cost for installation and configuration
Data transferEgress varies with bytes and network pathInternal network and connectivity costs
Vendor lock-inProprietary transformation logic, platform-specific featuresProprietary mapping formats, custom configurations
Scaling economicsElastic, billed on provisioned or consumed capacityOver-provision for peaks

Read down the columns and the same pattern repeats. Cloud keeps the bill small when demand is small but lets it climb without warning, and on-premise fixes the bill in advance whether or not you use what you bought. Each side reaches those numbers by a different route, and the route decides how much room you have to move the bill later.

How Does Cloud ETL Impact TCO?

Cloud deployments move money out of purchases and into a recurring bill, then let that bill move with demand. The three areas below account for most of the variation between a predictable cloud invoice and a surprising one.

Shifts Spend From Purchases to Subscriptions

Cloud replaces the server purchase with a bill for metered compute capacity and runtime, storage, requests, and networking. AWS Glue and Azure Data Factory both fold provider-managed infrastructure, patching, and high availability into that bill. The practical effect on a cloud ETL deployment is a small monthly charge in place of a large one-time purchase, which suits teams without capital to commit and without staff to run hardware.

Capacity Bills by Configured Size and Runtime

Billing follows the capacity you configure and the time it runs, whether or not that capacity produces useful work. Effective AI cost management can help teams monitor compute usage and avoid unnecessary spending on cloud ETL workloads. In AWS Glue, the worker type configuration fixes a data processing unit (DPU) multiplier per worker, from one unit on G.1X up to eight on G.8X, and AWS charges by the DPU-hour after a one-minute minimum. A deterministic error with MaxRetries set to 10 therefore produces 11 billable attempts. Azure Data Factory meters orchestration activity runs, Copy activity data integration unit hours, and Mapping Data Flow vCore-hours separately, and its minimum data flow cluster runs eight vCores with a billable warm-up period.

Residency Settings Carry Their Own Charges

Keeping data in a specific region or using client-managed encryption can add key-management or redundancy charges, though providers expose these as configuration options rather than a premium tier. Workloads under cross-border transfer restrictions meet those charges first, which puts cost monitoring inside the architecture decision for them.

How Does On-Premise ETL Impact TCO?

On-premise deployments answer the same three questions in the opposite order, paying early for capacity and control that cloud rents out monthly.

Front-Loads Spend Into Year One

Installation and configuration, commercial licenses, and servers, storage, and networking gear all land in the first year. After that, spend settles into license renewals and hardware maintenance contracts, with engineers on call for patching and capacity tuning. Cash flow feels that difference long before a three-year total does, which is why the two deployments can look further apart in year one than they turn out to be over the full term.

Capacity Is Sized for the Peak

Capacity changes arrive by purchase order instead of a console setting, so teams provision for their busiest week and carry that hardware through the quiet ones. Paying for idle capacity rarely appears in an initial budget and often dominates the later years of ownership. The upside is a bill that does not move when a backfill runs long or a job retries.

Keeps Residency Control In-House

Source payload data can stay inside infrastructure your own team operates, with encryption standards, access policies, and audit cadence set in-house. Deployment location sets that boundary, and configuration keeps it. Integrations, remote support paths, telemetry, backups, and operating procedures each open a route out of the environment, and they stay open until someone closes them deliberately.

How Do Hybrid Models Change the Equation?

A hybrid deployment keeps the data plane in a customer-controlled virtual private cloud (VPC) or on-premises environment while orchestration runs from a cloud control plane. The data plane runs connectors, reads sources, writes destinations, and consumes infrastructure inside the customer's environment. The control plane coordinates schedules, configuration, status, and monitoring. For standalone options, see our guide to data orchestration software.

Hybrid Produces Two Invoices

The customer pays for data-plane compute, storage, private networking, and any provider transfer charges incurred inside their own account, and the vendor charges for control-plane access, orchestration, or usage. Hybrid may land below or near a pure on-premise stack when it cuts hardware requirements and duplicated operational work, though the outcome depends on the specific product and commercial model. Model both invoices directly, because no universal range applies.

Control-Plane Availability Is a Priced Assumption

Some hybrid agents stop scheduling or syncing when they lose the control plane, while other architectures keep ingesting to local object storage but cannot serve consumers, start new workers, or reconcile configuration changes. Price the availability pattern you actually need, including local queue capacity, recovery procedures, and the cost of delayed pipelines during an interruption.

Workload Placement Drives the Hybrid Savings

High-volume, low-risk transformations can burst to the cloud during spikes while personally identifiable information (PII) and financial transactions process locally to meet residency rules. That split reduces on-premise over-provisioning without inviting cloud-only egress volatility, and one squad manages every pipeline through a single control plane instead of staffing each environment separately.

Which Deployment Offers the Lowest Long-Term TCO?

The winner depends on workload variability, utilization, staffing, existing infrastructure, networking, and compliance requirements. Each model has a demand profile it fits.

Cloud Fits Unpredictable Demand

Usage-based pricing charges for metered capacity, runtime, storage, requests, and transfer without an infrastructure purchase, and capacity moves up during a busy quarter and back down immediately afterward. Those benefits favor workloads that need rapid capacity changes and teams that would prefer not to own infrastructure. They fade once utilization is high and steady, since paying a variable rate for constant demand is an expensive way to buy predictable capacity.

On-Premise Fits Steady Utilization

On-premise makes financial sense when utilization stays consistently high and facilities, hardware capacity, and operations staff already exist. Financial services and healthcare teams accept the premium when complete control over data residency architecture and audit access is non-negotiable, and manufacturing or telecom organizations with steady high-volume loads often find the predictability worth it once their utilization and staffing assumptions hold up.

Hybrid Fits an Uneven Demand Curve

Organizations whose demand sits flat most of the quarter and then triples for a week pay either way under a single-model deployment: cloud charges a variable rate for the flat baseline, and on-premise sizes hardware for the spike and idles it afterward. Splitting the two is the shape hybrid is built for, and it is why regulated workloads with uneven demand keep converging on it.

How Do You Evaluate ETL TCO for Your Company?

Start with a reproducible model built on your own costs and workload. For each deployment, calculate three-year TCO from implementation, platform fees, infrastructure, data transfer, and support, then add fully loaded labor, compliance, expected downtime, and refresh or migration costs, and subtract whatever the hardware is worth at the end of the term. Keep every assumption in the same unit and time period so one option does not carry staffing or networking costs the other quietly omits.

Some inputs resist estimation and reward direct measurement. Downtime has a public benchmark: Uptime Institute reported in its 2026 annual outage analysis that 57% of surveyed operators said their most recent major outage cost more than $100,000, and 1 in 5 put it above $1 million.

Lock-in exposure comes from inventorying custom code, proprietary formats, downstream tests, and the parallel-run period a cutover would require. Data migration tools with built-in validation can shorten that parallel run, which lowers the exit cost you are modeling. Performance waste comes from modeling useful output per billed worker-hour or per provisioned server, then stress-testing retries, full reloads, warm-ups, idle capacity, and backfills.

Then run the model three times, because one set of numbers only describes one version of your workload:

  • Base case: current volumes and run frequency, with nothing else moving.
  • Growth case: data volume, retention, connector count, and concurrency raised to your forecast.
  • Stress case: backfills, retries, regional copies, incident recovery, and peak capacity landing together.

Each deployment needs different inputs inside those scenarios. For cloud, model worker size, runtime, retry count, timeout, storage, API requests, and egress. For on-premise, model peak capacity, utilization, power, cooling, support, staff, and the next hardware refresh. For hybrid, add the control-plane subscription to customer-paid data-plane infrastructure and networking, and include how your wider data architecture affects compute, storage, and staffing.

How Does Airbyte Flex Support Hybrid ETL Deployments?

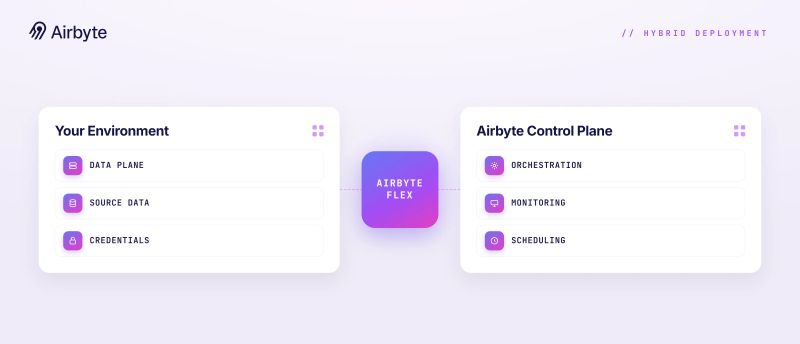

Airbyte Flex implements the hybrid split described above. Airbyte operates the control plane while the data plane, along with your records, credentials, keys, and compute, runs in your environment, though some metadata such as cursor and primary-key values sits in the control plane. Pipelines use the same 700+ connectors and the same interface as the fully managed service, so a hybrid deployment does not narrow what you can connect.

For a TCO model, that division maps onto the two invoices cleanly: data-plane compute, storage, and networking are billed inside your own cloud account or data center, and Airbyte bills the control plane. The same replicated records are what an in-boundary retrieval stack indexes, so agent reads inherit the boundary and access controls the pipeline already enforces.

What Comes After Your First ETL TCO Decision?

Revisit the deployment choice on a schedule. As workloads grow, utilization, staffing, transfer paths, compliance controls, and recovery requirements all move, and an architecture that matched your demand curve two years ago can quietly stop matching it.

Airbyte's data movement platform is built for teams that expect that trade-off to move. Connector coverage stays the same across deployments, pipelines run on capacity you can place where the model says it belongs, and Airbyte Flex keeps the data plane inside your environment when residency or audit requirements decide the architecture.

Bring your own volumes, utilization, and compliance requirements to the comparison. Get a demo to walk through a hybrid deployment against your ETL TCO model.

Frequently Asked Questions

What Is the Biggest Hidden Cost in ETL Deployments?

Specialized staffing usually outruns the software line. On-premise deployments need dedicated administrators, and cloud platforms still require engineers fluent in cost governance and performance tuning. Production coverage across upgrades, incidents, security patches, and after-hours recovery turns a headcount line into the largest single item in most models.

When Does Cloud ETL vs. On-Premise ETL Favor On-Premise?

On-premise becomes cost-effective when workloads run predictably and consistently, strict data sovereignty requirements apply, or data center capacity, power, space, and operations staff already exist. Concurrency, scan ratio, retention, compression, staffing, and egress all shift the break-even point well past what volume alone would predict.

What Compliance Costs Belong in a Hybrid Budget?

Model compliance tooling, audit preparation, security consulting, private connectivity, logging, and incident response as separate line items. A flat percentage uplift hides which one is growing. Hybrid adds network configuration and monitoring work that neither single-model deployment requires, and healthcare and financial services deployments carry more of it.

How Do I Calculate the True Cost of Data Egress in Cloud ETL?

Count the bytes actually transferred over each billable path, including analytics tools, backup systems, other regions or availability zones, network address translation (NAT) gateways, the public internet, and on-premise environments. Replication, retries, compression, and multiple destinations make transferred volume diverge sharply from raw ingestion volume, so per-path accounting beats a single blended estimate.

How Does a Control-Plane Outage Affect a Hybrid TCO Model?

Price it as an availability requirement. Ask the vendor whether the data plane keeps ingesting without the control plane, then cost the local queue capacity, recovery procedure, and business impact of delayed pipelines for the outage duration your architecture would experience.
